Get Involved!

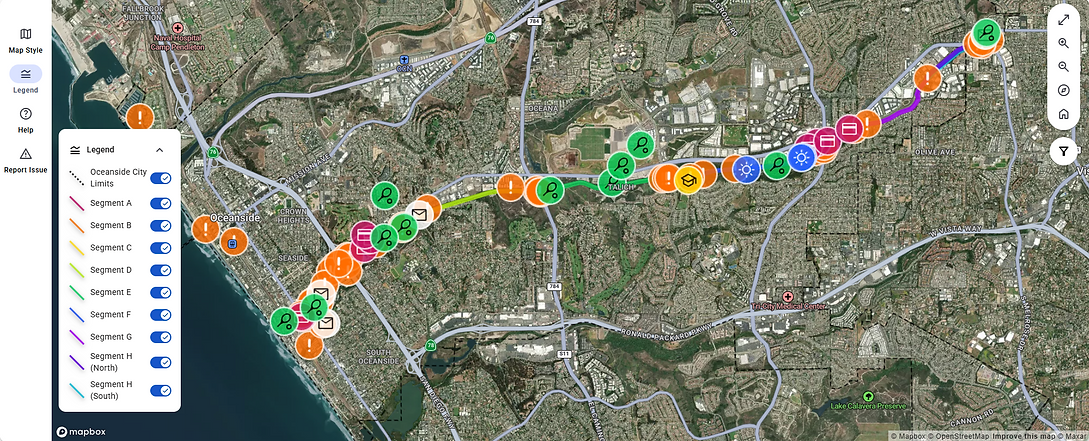

We've heard your input on three different alternative alignments for the Oceanside Inland Rail Trail and have developed the preliminary design concepts and a Draft Feasibility Study. We want to hear what you think! Take our online survey to share your input

Results of Phase 2 Engagement

The second phase of engagement focused on sharing three alternative alignments for the Inland Rail Trail and gathering community input. Engagement activities included two pop-up events, a community open house, and an online survey. In total, nearly 1,100 people were engaged, including 977 survey responses and more than 1,100 individual comments.



Key themes from Phase 2 engagement include:



  • Safety is the top concern. Participants stressed the need for lighting, safe crossings, separation from vehicle traffic, and addressing safety in isolated areas.

  • Preference for separation from traffic. Many participants favored Alignment A (South Side of SPRINTER Tracks) because it provides a scenic route away from vehicles and fewer intersection crossings.

  • Trail use will be primarily for recreation and exercise. Most participants said they would use the Inland Rail Trail for walking, biking, or fitness.

  • Amenities matter. Suggestions included bike parking, landscaping, shade, benches, and restrooms, with the San Luis Rey Trail cited as an example to follow.

  • Design priorities. Participants ranked access, stress level, route directness, cost, and topography in that order of importance.

Phase 2 Engagement Timeline



  • March 1–31, 2025

    • Online survey open (977 responses)

  • March 15, 2025

    • Pop-up event at Mance Buchanon Park (approx. 50 attendees)

  • March 17, 2025

    • Community workshop open house at Oceanside City Hall (20 attendees)

  • March 22, 2025

    • Pop-up event at Oceanside Pier (approx. 40 attendees)

Results of Phase 1 Engagement

The first phase of the project focused on Existing Conditions within the project corridor. We hosted two pop-up outreach events and conducted an online survey. In total, we engaged more than 500 people! Below are some of the key themes that we learned through these public engagement activities:



  • The project enjoys broad support from those that were engaged

  • Safety is a primary concern. Those engaged cited the following:

    • There was a strong desire for separation between pedestrians and bikes/e-bikes

    • Road crossings need to be safe

    • Engineering measures should be taken to ensure personal safety

  • Trail connectivity is a priority

  • Most people would use the Inland Rail Trail for biking/e-biking (more than 60%)

  • The Inland Rail Trail would help the community be more active and access public recreation

  • Shade, lighting, and native landscaping are important elements to incorporate into the project

Phase 1 Engagement Timeline

For a detailed summary of Phase 1 of Engagement, see the Community Outreach and Engagement Summary on our Resources tab!

  • October 1, 2024 – Official Launch of Phase 1 of Engagement

    • TIDE Newsletter article

    • Phase 1 online survey opened

    • Mailer sent to the nearest 1,000 residents to the Oceanside IRT study area

  • October 10, 2024

    • City of Oceanside social media post

  • October 12, 2024

    • Pop-up event at Oceanside Pier

  • October 15, 2024

    • Sidewalk decals placed throughout Oceanside with a QR code to the project website

  • October 17, 2024

    • City of Oceanside social media post

  • October 19, 2024

    • Pop-up event at Wagner Aquatics Center and Senior Center

  • October 31, 2024 – Official close of Phase 1 of Engagement
